top of page

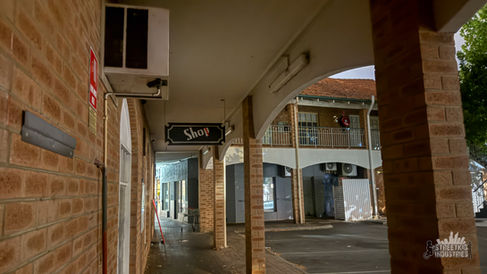

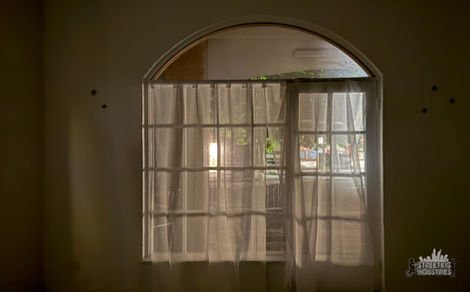

Claremont St Quentin 22 Shops

The shops at 22 St Quentin Avenue, Claremont, were part of a two-storey complex with shops at street level, offices and a large bitumen car park. The complex appears to have been built in 1982 and can be seen in aerial photographs from 1983.



It stood on a 1,951m² block at the corner of St Quentin Avenue and Church Lane, a short walk from Claremont train station. Behind it, facing Stirling Highway, was the former Methodist church, which later housed the Claremont Community Hub and town library.

July 2021

Before the shops were built

Before the shops and offices were built at 22 St Quentin Avenue, the land behind Claremont’s Methodist church was used as part of the church grounds. A tennis court stood towards St Quentin Avenue and the manse, where the minister lived, was located close to Stirling Highway.



Claremont is on Whadjuk Noongar Country, in an area known as Mooro. In 1830, a year after the Swan River Colony was established, John Butler selected land in what later became Claremont and Peppermint Grove. He established a farm and the district became known as Butler’s Swamp. The road between Perth and Fremantle, now Stirling Highway, was in use by 1860. The railway followed in 1881 and the present Claremont station building dates from 1886.



Claremont’s Methodists began meeting in 1895 and held one of their first services in the local school. On 14 November 1896, the Rev. G. E. Rowe laid the foundation stone for their first church, a weatherboard building facing the Perth-Fremantle road. The church’s title records identify part of the grounds as Lot 75 on Plan 51, within Swan Location 701. The street behind the church was then called Divers Street. It was formally dedicated for public use in January 1902 and renamed St Quentin Avenue in 1925 to commemorate an Australian victory during the First World War.



In 1922, the weatherboard church was moved about 15 metres back from the road to make room for a larger brick church. The new building was designed by James Hine and built by Singleton and Pitman. Its first services were held on 25 February 1923, and the old church became the hall. A 1925 sewer plan shows the two buildings along with the tennis court and manse. The State Library holds a photograph of the church’s tennis club from 1930.

​

The old hall was badly damaged by fire in 1946. It was repaired and enlarged in time to host some of the church’s jubilee celebrations that year. In January 1947, the Government Gazette listed the Rev. Cecil Raymond Phillips at 127 Stirling Highway, the address associated with the manse.



In 1980, the Uniting Church decided to sell the property. Claremont Town Council bought the brick church for $170,000 in September 1981 and converted it into a town hall. The old weatherboard hall was demolished during the conversion. Behind the church, the two-storey complex of shops and offices at 22 St Quentin Avenue appears to have been built in 1982. The building and its bitumen car park were in place by the time aerial photographs were taken in 1983.

December 2025

Church Court

The title for the shops block was issued to Property Nominees Pty Ltd on 29 January 1982. It carried over a mortgage to Custom Credit Corporation Limited that had been registered in July 1981.



Ownership

  • 1984 - William Edgar Evans and Anthea Gay Evans of Yelverton bought the property for a reported $1.47 million. The transfer was registered on 1 November, and the 1981 mortgage was discharged that day.

  • 2013 - The property reportedly sold for $7.4 million.

  • 2018 - acting as trustee for the bought the property off-market for $12.35 million. The transfer and a mortgage to HSBC Bank Australia were registered on 24 July. The building was reported as fully leased at the time, with eight ground-floor shops and ten upstairs tenancies across 1,076 m² of lettable space.

January 2026

Businesses at Church Court

  • July 1983 - was at Shop 9. The Government Gazette listed Bodall Pty Ltd as trading under that name, with David Hugh McKenzie in charge. Stephen Adair Olifent was also listed at the shop.

  • April 1986 - Don Thompson ran Cornucopia Confections at Shop 16, selling imported chocolates and other confectionery. He offered gift wrapping, delivery orders by phone and reminders for birthdays and anniversaries.

  • August 1987 - was registered at Unit 30. The Dental Board was still listing the practice there in 2002.

  • February 1988 - operated by Allstate Holdings Pty Ltd, was listed at Shop 2.

  • Later years - operated a Japanese restaurant and sushi train at No. 22.



In May 2000, the Town of Claremont listed the car park as Parking Station No. 2, with “Town Hall” in brackets. Between 2015 and 2019, some of the shops and offices were advertised more than once, with asking rents of about $23,000 to $24,000 a year.

​

Showroom X lease

Showroom X took a five-year lease of Suites 5 to 9 from 5 March 2021. During negotiations, Synicast’s letting agent told the business about plans to demolish Church Court and build a tower with shops, commercial space and apartments. The lease included a clause that would allow Synicast to end it early for redevelopment after a minimum of 18 months. After a Supreme Court appeal sent the matter back for reconsideration, the State Administrative Tribunal approved the clause on 26 June 2023.

January 2026

The Quentin Square redevelopment

Discussions with the Town of Claremont began after Synicast bought Church Court in 2018. The State Design Review Panel looked at the plans three times between September 2020 and February 2021. The developer lodged its application on 25 August 2021, and the state sent it to the Town for comment the following month.



The plans showed the two-storey shops and offices and their bitumen car park being demolished to make way for Quentin Square. The original proposal included 86 apartments, shops and dining premises at street level, offices above and four basement levels accessed from Church Lane. The state listed the development value at $108.9 million. The application went through the state’s Part 17 significant development pathway, with the Western Australian Planning Commission (WAPC) making the decision after seeking comments from the Town.



Synicast Pty Ltd owned the site as trustee for the Quentin Avenue Unit Trust. Kuraland, part of Malaysia’s LGB Group, is the developer. Pennock Architects designed the building, Scanlan Architects carried out further design work and Mettris Construction is the builder. HSBC registered a mortgage when Synicast bought the land in 2018.

August 2026

The former Methodist Church

The heritage-listed church at 327 Stirling Highway stood on a separate lot and was to be retained. The plans set the tower back from the highway and placed a lower section of the new building beside the church to keep views of it from the road. Steps and a landing added at the library entrance extended onto the shops block and were marked for removal. The proposed works included a new ramped path, landscaping along the highway, repairs to the mortar joints in the church façade and lighting for the building at night.



Community benefits

The developer’s Community Needs Assessment identified limited green space, poor walking links between public buildings and a shortage of small spaces that could be used for different activities. It also identified a need for places where people could meet informally, particularly seniors and families. During consultation, people said they wanted a larger town square with seating and landscaping, more places to eat and drink, and better walking access along Church Lane.



The plans included:

  • A small public park outside the former library, beside the church.

  • Pedestrian links between the former library, Church Lane and the town square.

  • Ground-floor cafés and dining spaces opening onto public areas.

  • An extension of the town square onto the Church Court side of St Quentin Avenue.



The developer put these public spaces forward as part of its case for extra height and floor space.

October 2026

Council objections and state approval

On 2 November 2021, Claremont Council asked the WAPC to hold off until the town centre structure plan and the review of the state’s activity centres policy were finished. If the WAPC went ahead with a decision, the council recommended refusal. Its concerns included the height and amount of floor space, parking, stormwater and traffic. It wanted the traffic study to account for the new bus terminal, the Hungry Jack’s drive-through and a possible westbound right-turn lane from Stirling Highway into Church Lane.



The WAPC approved the 19-storey development on 1 June 2023, with 39 conditions.



Changes to the approval

In July 2023, the developer asked the State Administrative Tribunal to review conditions covering parking, vehicle access and public spaces. When the matter went back to the WAPC in 2024, the Town renewed its objection to the height. It argued that the building exceeded both the nine storeys set for the site in the town centre structure plan and the 13 storeys then being considered for landmark sites that qualified for extra height.



The WAPC kept the approval in place and approved revised plans on 17 October 2024. The apartment count fell from 86 to 80 after six pairs of apartments were combined. The revised conditions also required the developer to pay the Town $234,000 before the building could be occupied, in place of providing 12 visitor parking bays on site.



The conditions require an easement to protect public access to the town square extension, the former library forecourt and the pedestrian links. A management plan must set out opening hours and maintenance arrangements. Unhosted short-stay accommodation is limited to apartments on levels 3, 4 and 5 and requires its own management plan. The development must also achieve a 5 Star Green Star rating or an equivalent standard.



The separate amendment to the town centre structure plan, which sets out how extra height and floor space can be considered on landmark and gateway sites, was approved on 16 March 2026.



Demolition and construction

Church Court was demolished during the week beginning 19 January 2026. The Town approved a partial closure of the northbound lane of Church Lane from 2 March 2026 to allow Mettris to carry out construction work. The closure is expected to remain in place until November 2028. Mettris lists 2028 as the scheduled completion year for Quentin Square.
